Add to homescreen

If you want to add this app to home screen tap and then ‘Add to Home Screen’.

Mudfoot moves during planned maintenance

What happened - icon

What happened?

During planned maintenance, a position transducer was being replaced on mudfoot leg 3 of a drilling leader tower (DLT).

Scaffolding was erected on the mudfoot, and chain blocks were installed to secure it.

Unexpected movement of all three cylinders caused one chain block to fail, resulting in the mudfoot leaning towards the vessel and the scaffolding losing stability.

The maintenance team promptly evacuated to a safe area because of the risk of further movement.

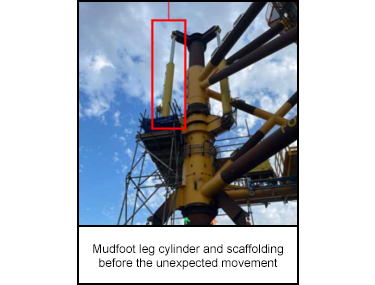

Mudfoot leg cylinder and scaffolding before the unexpected movement
What happened - icon

Why did it happen?

Hydraulic check valves failed, causing unintended cylinder movement.

Lifting gear was underrated, with a 3.5-tonne (7,716 lb) safe working load (SWL) instead of the required 10 tonnes (22,046 lb).

Inadequate shift communication led to incorrect rigging application during preparation.

Scaffolding legs placed on the mudfoot increased stability initially but created a hazard once the mudfoot shifted.

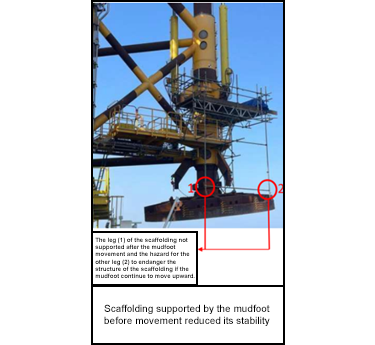

Scaffolding supported by the mudfoot before movement reduced its stability
What happened - icon

What did they learn?

Critical equipment, including scaffolding, rigging, hydraulic systems, should be properly rated, inspected, and supported with additional controls to prevent uncontrolled movement.

Clear communication of method statements and thorough shift handovers are essential to avoid misapplication of rigging or procedures.

Using mechanical locks, tensioned rigging, and enhanced isolation, such as extra check valves, significantly reduces risks during maintenance on moving structures.

What happened - icon

Ask yourself or your crew

How do we verify that all lifting and rigging equipment being used has the correct SWL and has been inspected before the task?

What steps ensure that method statements and lock-out/tag-out (LOTO) requirements are clearly communicated and understood during every shift handover?

How can we design scaffolding and access methods so they remain stable if there is unexpected movement?

What additional hydraulic isolation or mechanical locking measures should be in place before starting similar maintenance?

  • What happened?

    During planned maintenance, a position transducer was being replaced on mudfoot leg 3 of a drilling leader tower (DLT).

    Scaffolding was erected on the mudfoot, and chain blocks were installed to secure it.

    Unexpected movement of all three cylinders caused one chain block to fail, resulting in the mudfoot leaning towards the vessel and the scaffolding losing stability.

    The maintenance team promptly evacuated to a safe area because of the risk of further movement.

    Mudfoot leg cylinder and scaffolding before the unexpected movement
  • Why did it happen?

    Hydraulic check valves failed, causing unintended cylinder movement.

    Lifting gear was underrated, with a 3.5-tonne (7,716 lb) safe working load (SWL) instead of the required 10 tonnes (22,046 lb).

    Inadequate shift communication led to incorrect rigging application during preparation.

    Scaffolding legs placed on the mudfoot increased stability initially but created a hazard once the mudfoot shifted.

    Scaffolding supported by the mudfoot before movement reduced its stability
  • What did they learn?

    Critical equipment, including scaffolding, rigging, hydraulic systems, should be properly rated, inspected, and supported with additional controls to prevent uncontrolled movement.

    Clear communication of method statements and thorough shift handovers are essential to avoid misapplication of rigging or procedures.

    Using mechanical locks, tensioned rigging, and enhanced isolation, such as extra check valves, significantly reduces risks during maintenance on moving structures.
